Data Centers: Daily Notes | June 22, 2026

Microsoft breaks ground on a $1B-plus LaPorte campus while Citrus County rejects a 1,356-acre industrial park and pauses spread from Illinois to Montana.

Data Centers: Daily Notes | June 22, 2026
Photo by sergey raikin / Unsplash
Your daily digest of Data Center regulatory shifts and decisions.

At A Glance 🔽

  • LaPorte, IN breaks ground on a Microsoft campus topping $1 billion, eventually up to 17 buildings across 1,800 acres.
  • Citrus County, FL planning board recommends denying a 1,356-acre data center industrial park after 9-hour meeting.
  • Yellowstone County, MT opponents submit a ballot initiative to give voters a say over data centers near Broadview.
  • Lake County, IL board pauses application review and moves toward an eight-month moratorium in unincorporated areas.
  • Henry County, IL board approves a 12-month moratorium on data centers.
  • Elk River, MN council takes no action on a 33-megawatt proposal, continuing the hearing to July 6.
  • Xenia, OH introduces a one-year moratorium, with a vote and public hearing set for June 25.
  • Emporia, KS commission drafts large water-user rules ahead of the proposed Flint Hills Digital Campus.
  • Whitley County, IN planners open a June 24 listening session before any formal applications arrive.
  • La Crosse County, WI board approves an 18-month moratorium on new data center development.

LaPorte, Indiana

Indiana - Microsoft Local
Microsoft is working through the datacenter development process in northern Indiana. Aligned with Microsoft’s global commitments and our Datacenter Community Pledge, we have created the Community-First Infrastructure Initiative as a concrete step toward being a good neighbor where we build and operate. Explore more datacenter topics Local updates

Microsoft broke ground on a data center campus in LaPorte that the mayor says surpasses all private investment in the city's history combined, an investment topping $1 billion.

Crews have spent weeks grading the 500-acre site on Boyd Boulevard, and building construction is set to begin in less than 30 days. Microsoft plans to operate three buildings by 2029, then add three more as quickly as it can build them. Running all six will take more than 600 full-time employees, with another 11 structures planned later on 1,300 adjacent acres the company is buying. At full ramp, more than 2,000 construction workers will be on site daily over a roughly 10-year buildout.

Microsoft breaking ground in La Porte Data Center | Brad Smith, Linkedin

Microsoft decided earlier this year not to seek tax abatement on any of its data center projects nationwide, so LaPorte expects tens of millions of dollars annually for the city and several million for the school corporation under a 20-year agreement. The company is also paying the city $17 million for more than 100 acres of municipally owned land included in the purchase. The school board had weighed asking voters for a property tax increase but dropped the idea given the incoming revenue.

Yellowstone County, Montana

Data center opponents have submitted a ballot initiative seeking some control over the projects in Yellowstone County, where Quantica hopes to build a data center and power plant near the substation at Broadview.

Ballot initiative on data centers.

Quantica's applications add up to 8,835 megawatts, about five times what NorthWestern Energy owns for generation across Montana. The proposed gas plants alone would generate 1,785 megawatts, more than the combined capacity of every gas plant operating statewide. The facility would tie into power lines running from Colstrip to the West Coast.

If the initiative qualifies, county residents could vote on the matter in November. Backers want a mechanism to weigh in on energy consumption and environmental impacts before a project of this size moves forward.

Henry County, Illinois

📆
Jun 18, 2026
COUNTY BOARD AGENDA

The Henry County Board approved a 12-month moratorium on data centers on Thursday, alongside a separate pause on carbon sequestration projects.

Board member Jill Darin, who introduced the data center motion, said her committee wanted time to determine what ordinances are needed around environmental and residential impacts as the facilities proliferate nationwide. To the county's knowledge, no landowners have been contacted about a data center, and Darin described the move as proactive.

Lake County, Illinois

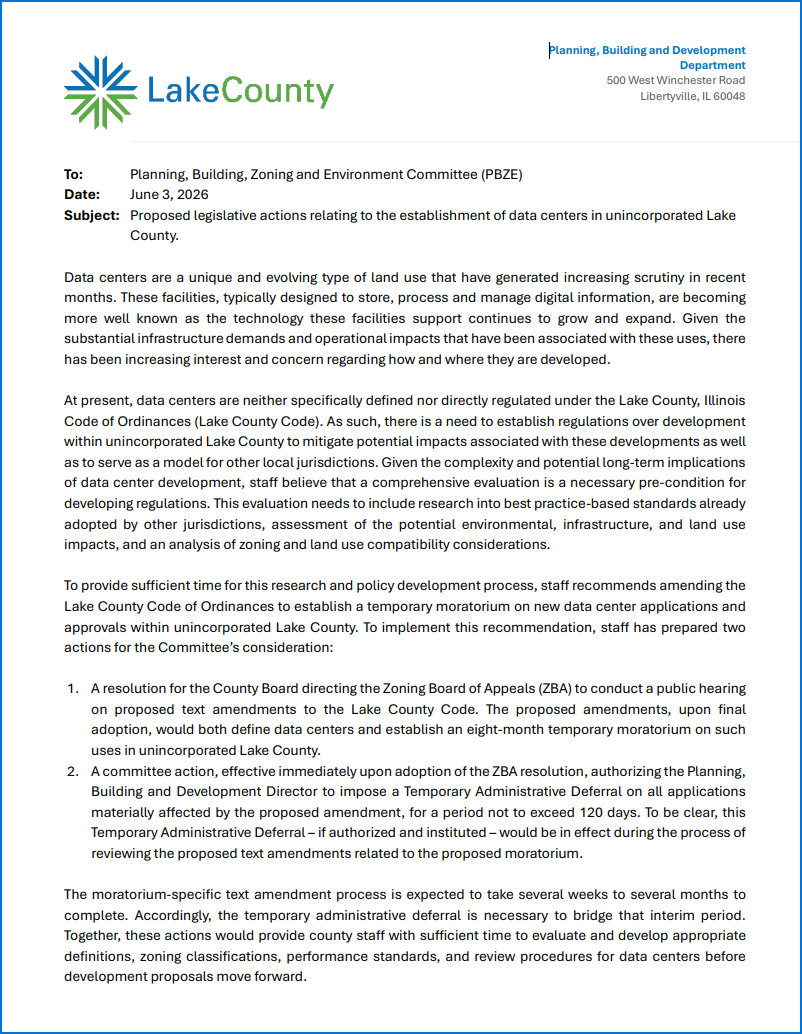

Lake County Initiates Public Hearing on Temporary Moratorium for Data Centers in Unincorporated Areas

The Lake County Board voted to pause data center approvals in unincorporated areas while it develops regulations, with one member saying the facilities bring "serious concerns".

Proposed legislative actions relating to the establishment of data centers in unincorporated Lake County

The board approved a resolution directing the Zoning Board of Appeals to hold a public hearing on amendments that would define data centers and establish an eight-month temporary moratorium. That hearing is expected later this summer. The board's action did not yet impose the eight-month pause, but it did authorize the Planning, Building and Development department to halt review of data center applications for up to four months. Data centers are not currently defined or regulated under county ordinances.

Citrus County, Florida

Planning and Development Commission Board - June 18, 2026 Jun 18, 2026
Planning Commission meeting. Vote scheduled? TBD.

The Citrus County Planning and Development Commission voted to recommend denying a proposal to expand an industrial park to 1,356 acres for large-scale data centers, siding with residents after a nine-hour meeting.

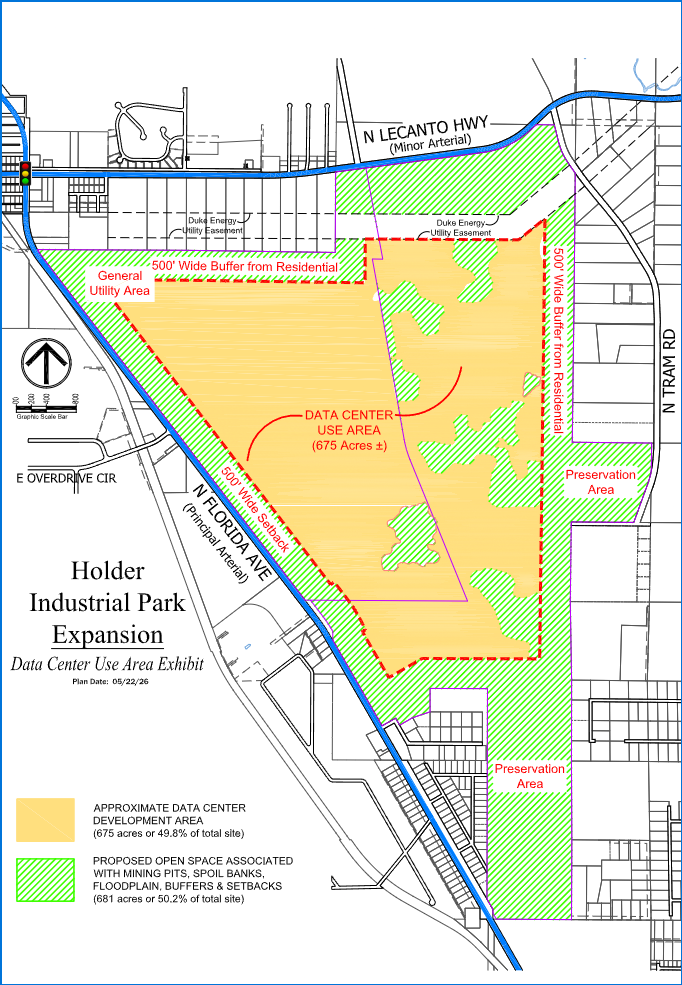

Exhibit C - Data Center Use Area Map submitted May 29 2026

The Deltona Corporation sought to rezone the land from residential to heavy industrial but could not say definitively what would go there, floating the possibility of a hyperscale facility and citing nondisclosure agreements that county officials said they were hearing about for the first time. Under questioning, a Deltona attorney said the developer aims to attract a data center with 450 to 500 megawatts of capacity that could use as many as 140,000 gallons of water in its first year. Deltona began the rezoning last summer after Amazon inquired about the site, but the company has since lost interest.

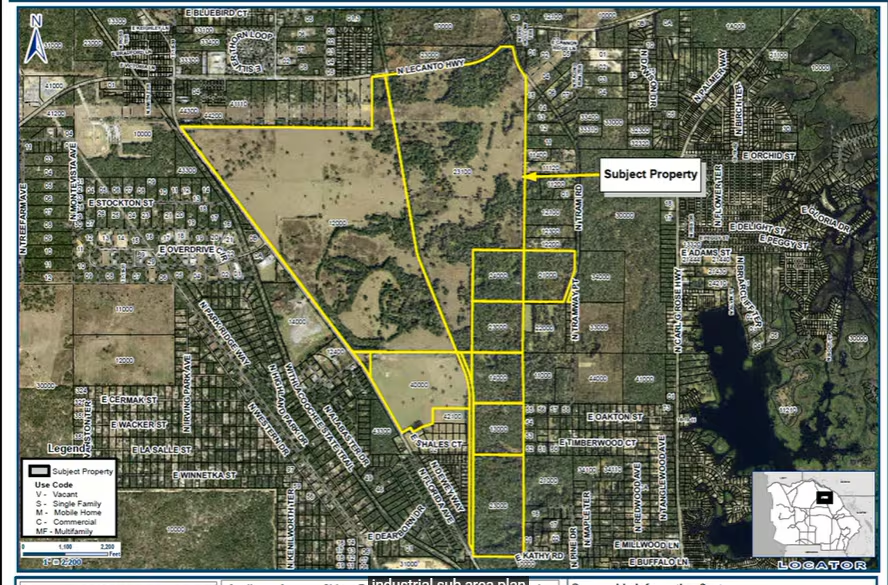

Aerial image shows proposed roughly 1,300 acres for an industrial park in Citrus County for Data Centers.

More than 200 residents turned out, every speaker opposed, criticizing a lack of transparency and few community benefits in an area that prizes its rural character. The vote is a recommendation only; the County Commission has final say and is expected to take it up July 14, unless it grants Deltona's request to delay until November.

Elk River, Minnesota

📆
Jun 15, 2026
City Council Meeting Agenda
4 Ordinance Amendment and Conditional Use Permit: Data Center, Michael Margulies, 19178 Industrial Blvd NW

The Elk River City Council took no action on a proposed 33-megawatt data center at a June 15 hearing dominated by opposition, continuing the matter to July 6.

Timeline
History April 27, 2026 · Ordinance amendment and conditional use permit applications submitted to City of Elk River May 16, 2026 · Notice of Public Hearing published by City of Elk River May 26, 2026 @ 6:30p · Public hearing @ Planning Commission meeting (video, resources) June 15, 2026 @ 6:00p · Public hearing @ City Council meeting (video, resources) Upcoming Written public comment may be submitted to the City of Elk River Community Development Department. Contact the department directly to confirm submission deadlines and procedures for each hearing date.

Michael Margulies of Elk River Capital LLC, operating as Swervo Development, wants to convert a vacant 62,000-square-foot former injection molding facility at 19178 Industrial Blvd. NW into a data center using a closed-loop glycol cooling system that needs water only during initial charging. Because data centers are not permitted in the city's Light Industrial district, the developer needs both an ordinance amendment and a conditional use permit; the city split those into separate phases, with the Planning Commission revisiting the amendment June 23 📆.

Draft Ordinance 6-18-2026 | June 23, 2026 Meeting

Elk River Municipal Utilities General Manager Mark Hanson said the city's system has capacity, with about 206 megawatts available against a peak demand near 76, and that the developer would cover all infrastructure costs and prepay electric bills. Residents pushed back anyway, raising concerns about low-frequency noise, property values, and proximity to schools.

Xenia, Ohio

Xenia City Council introduced a one-year moratorium on establishing data centers within the city, with a vote and public hearing set for June 25.

City Manager Brent Merriman said data centers are increasingly locating in Ohio for lower construction costs and water availability, but have not historically fit within the city's zoning code. The proposed pause would cover the submission, consideration, or approval of any application to establish, develop, or convert a structure into a data center, giving staff time to evaluate zoning while state and federal discussions continue. Mayor Ethan Reynolds moved on June 11 to extend the proposed pause from six months to one year.

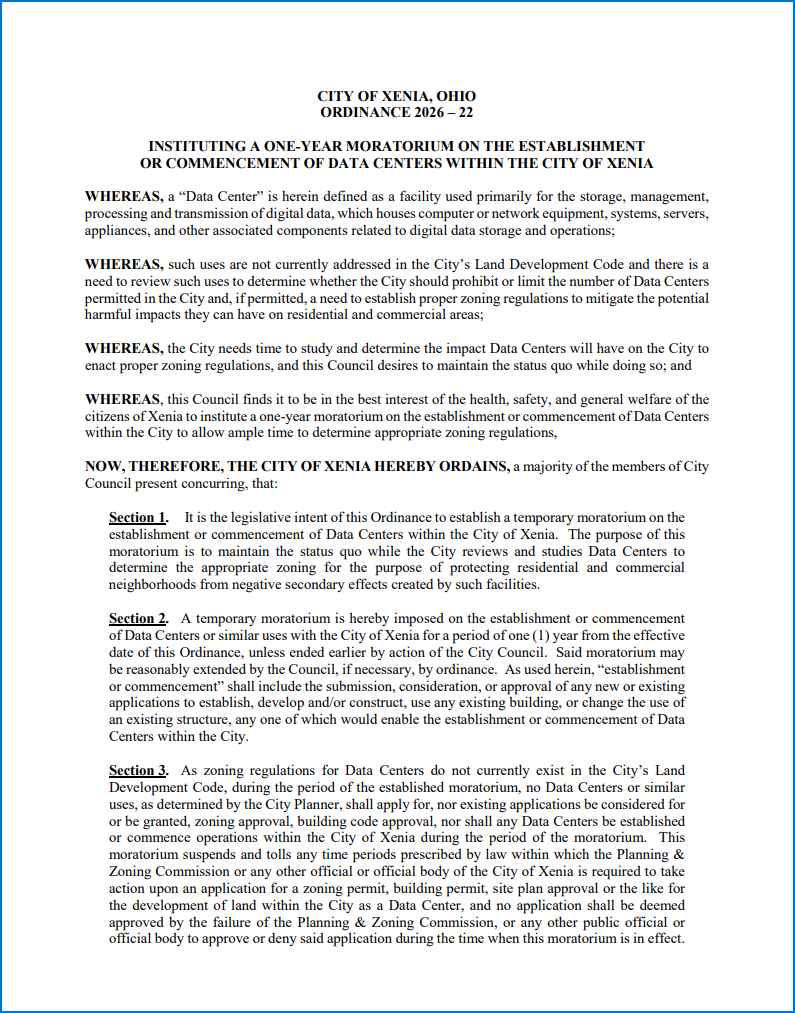

ORDINANCE 2026-22 INSTITUTING A ONE-YEAR MORATORIUM ON THE ESTABLISHMENT OR COMMENCEMENT OF DATA CENTERS WITHIN THE CITY OF XENIA | Page 16 of 21 June 25, 2026

Councilmember JD Mackiewicz said the main concern is facilities consuming 20 megawatts of power, more than twice what the city uses in a single building, on top of worries about water use, noise, and heat. If approved on June 25, the ordinance would take effect July 25.

Emporia, Kansas

Emporia leaders are drafting water regulations ahead of a possible data center, working to create a class of large water users and set what they would pay.

City Manager Trey Cocking told the City Commission the need is concrete, with a proposed data center, the Flint Hills Digital Campus, in the picture. "This is real, we know exactly what this looks like," he said, adding that the city wants a policy governing large users and stronger financial security from any developer before proceeding. The draft policy is intended to protect ratepayers and prevent harm to the city.

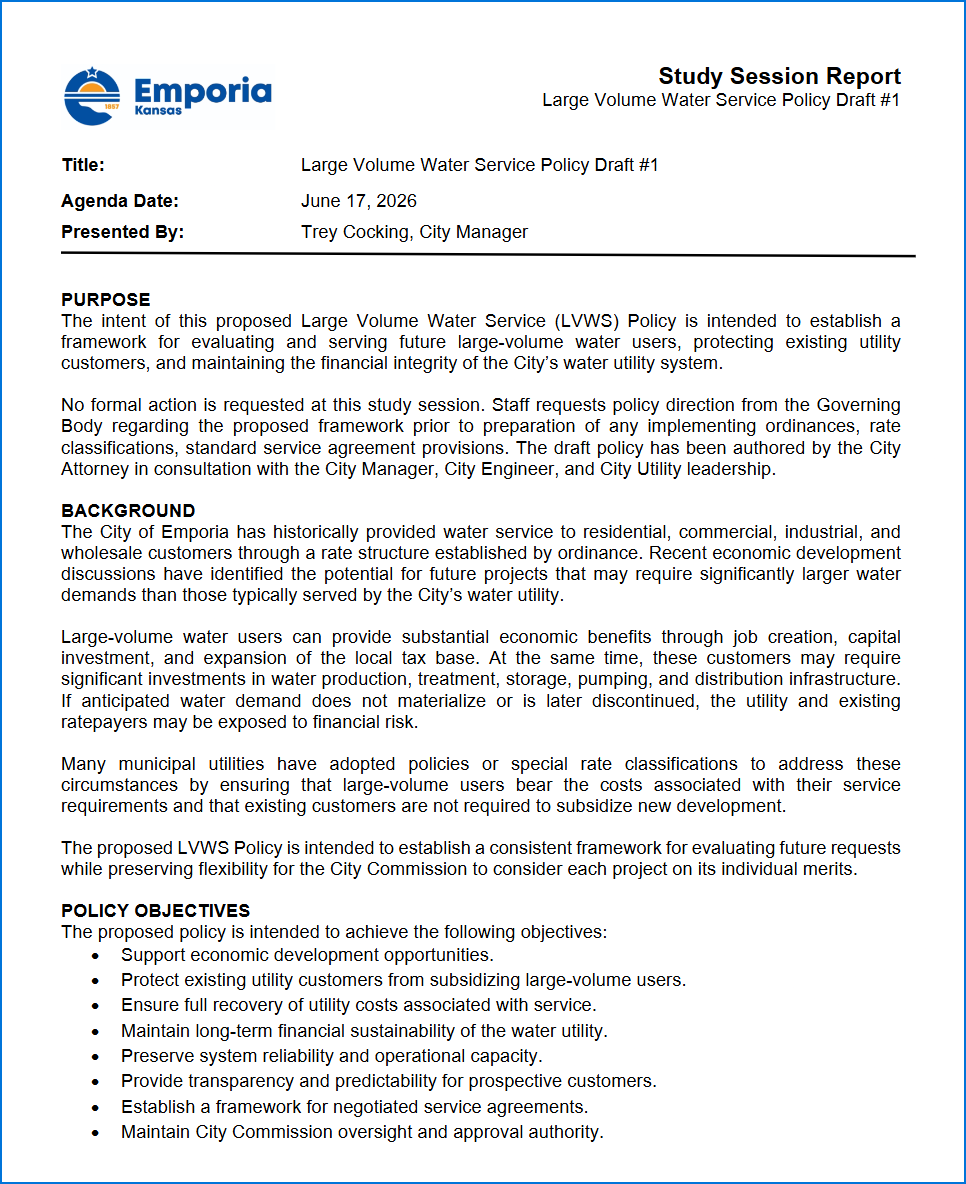

Large Volume Water Service Policy Draft #1

The commission says it has not had conversations with the proposed campus beyond an initial review of capacity. A special planning meeting and public hearing on a digital overlay district that would encompass the data center is scheduled for 6 p.m. Tuesday at the WLW Civic Auditorium.

Whitley County, Indiana

Whitley County planners are opening a public listening session on June 24 to shape potential data center zoning before any formal proposals arrive.

The Plan Commission will gather feedback at 7 p.m. in the county Government Center in Columbia City, with no votes or final decisions on the agenda. Planners say they have fielded inquiries about possible sites but received no formal applications, and want to set expectations and standards early. Officials are weighing electricity demand, water consumption, environmental impacts, and compatibility with surrounding land uses.

Planner Brent Bockelman is expected to present an overview of data center development and zoning considerations, and the session will be livestreamed. Residents who cannot attend may submit written comments through July 6.

La Crosse County, Wisconsin

The La Crosse County Board of Supervisors approved an 18-month moratorium on new data center decisions and development on Thursday, pausing county action while a special committee studies the industry's environmental and economic impacts.

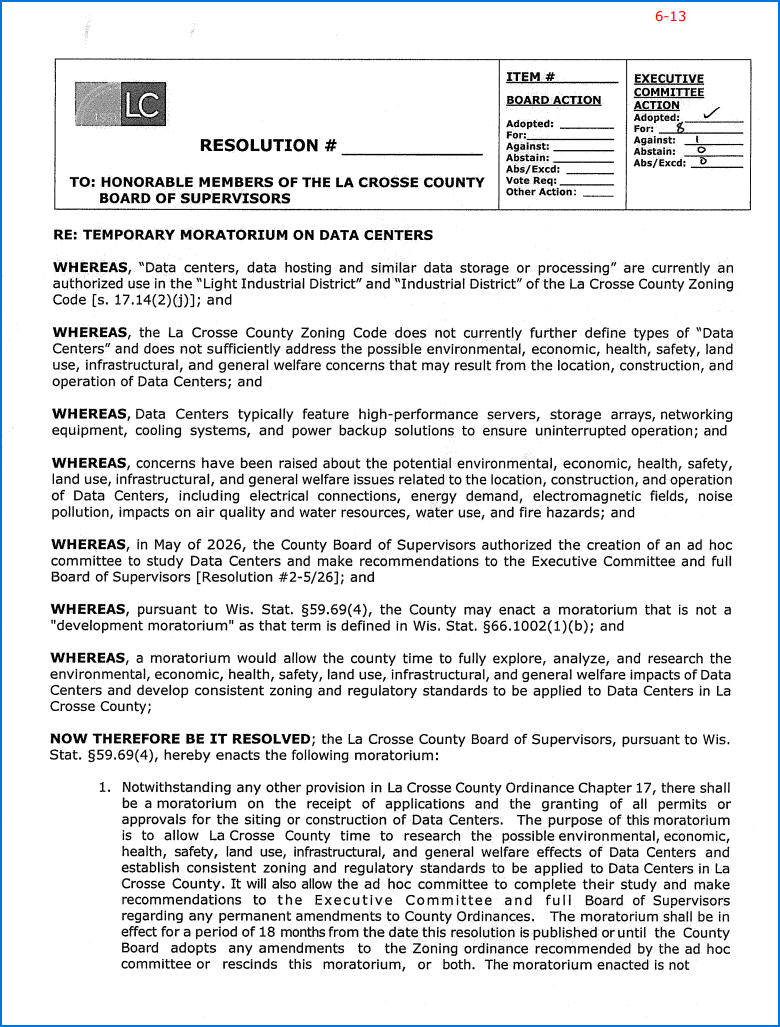

Item #6-13 Resolution Re: Temporary Moratorium on Data Centers

The board created the committee in May and tasked it with recommending future county policies. Supporters say the pause buys time to understand the local effects, and they note it does not bar data centers outright.
